Load-Bearing Wall Removal Toronto

Why Removing a Wall Changes Everything Have you ever stood in your kitchen or living room and wished the wall between them could disappear? You’re not alone. Many homeowners in Midtown Toronto reside in beautiful, older houses that weren’t designed for today’s lifestyle. Rooms are boxed in, natural light struggles to penetrate the space, and …

Bearing Wall Removal in Mid-Town Toronto for older homes

Removing a load-bearing wall is one of the most transformative renovations a homeowner can make — turning a closed-off floor plan into an open, light-filled living space. It is also one of the most technically demanding. The wall is a supporting part of your home, which means engineering, permits, and structural work must all be coordinated correctly before a single nail is driven.

This guide walks through what load-bearing wall removal in Toronto in 2026 actually involves — costs, beam options, permits, timelines, and the mistakes that can turn a clean project into an expensive one.

Quick answer: load-bearing wall removal cost in Toronto

Load-bearing wall removal in Toronto in 2026 typically costs $26,000–$48,000 for a full project, including engineering, permits, structural beam, demolition, drywall and finishing, and surrounding repairs. Simple, straight-span LVL beam installations in newer homes start around $26,000. Complex projects involving steel beams, multi-trade relocations (electrical, HVAC, plumbing in the wall), or older homes with hidden conditions land at the upper end of $40,000–$48,000+.

When the wall removal is part of a larger kitchen renovation — which is the most common scenario — the costs are usually integrated into the broader project budget. For full-kitchen renovation pricing, including wall-removal scope, see our Kitchen Renovation Cost Guide for Toronto 2026.

Why homeowners remove load-bearing walls

The most common reason is to convert a closed-off floor plan into an open-concept layout — typically opening the kitchen to the dining room, the dining room to the living room, or both at once. This is especially common in Toronto’s older housing stock:

  • Victorian and Edwardian homes in The Annex, Rosedale, and Cabbagetown with narrow centre-hall layouts
  • Post-war bungalows in North Toronto, Lawrence Park, and Leaside with formal living and dining separations
  • Semi-detached homes in Forest Hill, Davisville, and Moore Park with kitchen-at-the-back layouts that disconnect from family living areas
  • Mid-century homes in Don Mills, Hogg’s Hollow, and Lytton Park with compartmentalized main floors

Beyond aesthetics, removing a load-bearing wall improves natural light flow, makes the space feel significantly larger without adding square footage, increases functional family living space, and typically increases resale value when done properly.

How to tell if a wall is load-bearing

Not every interior wall is structural. The reliable way to determine if a wall is load-bearing is to have a structural engineer or experienced contractor assess it — but there are signs that point one way or the other.

Walls that are likely load-bearing:

  • Walls running perpendicular to the floor joists above
  • Walls directly above a beam, post, or load-bearing wall on the floor below
  • Walls in the centre of the home on a long axis
  • Walls under a stair, hallway, or roof ridge line
  • Exterior walls (almost always load-bearing in residential construction)

Walls that are likely not load-bearing:

  • Walls running parallel to floor joists
  • Short walls in finished basements with no structure above
  • Closet walls or partition walls dividing rooms within an open footprint

A "likely" assessment is not enough to start work. Toronto requires an engineer's report and structural drawings before a permit will be issued for any wall removal involving a suspected load-bearing structure. Cutting first and confirming later is how homes end up with sagging floors, cracked drywall, and emergency repair invoices.

The wall removal process — step by step

A correctly executed load-bearing wall removal follows a predictable sequence. Skipping any of these steps is the most common cause of cost overruns and structural problems.

1. Site assessment and engineering

A structural engineer reviews the home, identifies what loads the wall is carrying, and specifies the replacement beam (size, material, span, support points). Engineering fees in Toronto in 2026 typically range from $1,500 to $3,500, depending on complexity.

2. Permit application

Drawings and the engineer’s report go to the City of Toronto Building Permits Office. Standard review takes 2–6 weeks. Eligible projects under 100 m² can use the City’s FASTRACK program for 5–10 business-day approvals. For the full permit process, see our Toronto Building Permit Guide for 2026.

3. Temporary support installation

Before any wall is cut, temporary support walls go in on either side of the structure being removed to carry the load while the permanent beam is installed.

4. Wall demolition

The wall is removed in sections, with all electrical, plumbing, and HVAC services in the wall capped, relocated, or rerouted as needed.

5. Beam installation

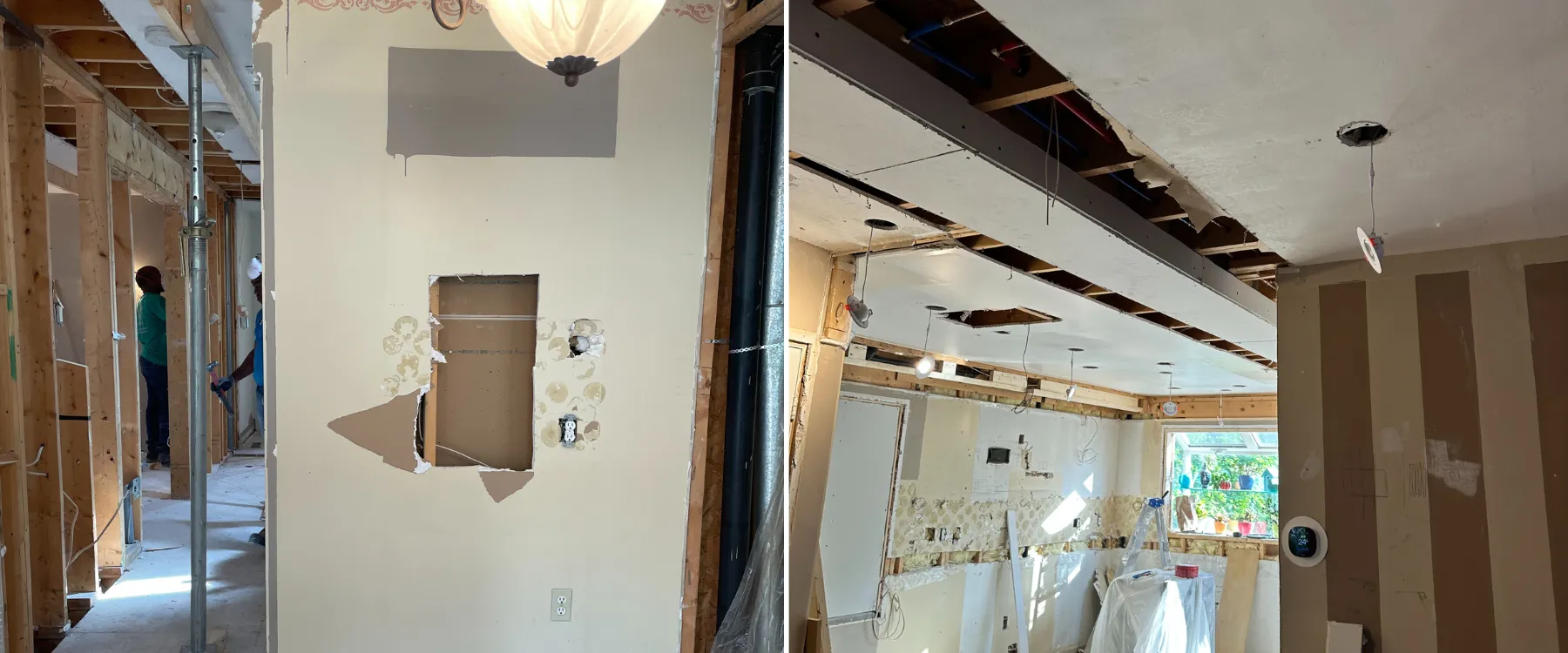

The replacement beam — LVL, steel, or engineered lumber,project’s depending on span and engineering — is installed and tied into the existing structure with proper bearing points and connections.

6. Inspection

City of Toronto inspector reviews the structural work before any drywall goes up. This is non-negotiable. Skipping inspection creates major problems at resale and insurance.

7. Finishing

Drywall, ceiling repair, flooring patching where the wall used to be, paint, and trim restoration. This is where the scope of the surrounding room can expand quickly if not planned in advance.

Beam options: LVL, steel, and flush vs dropped

The replacement beam is the most consequential structural and aesthetic decision in a wall removal project. Three main choices.

LVL (Laminated Veneer Lumber)

The most common choice for residential wall removals in Toronto. LVL beams are engineered wood products that handle most typical residential spans (up to 16–18 feet) at a reasonable cost. Easier to install than steel, and dimensions usually allow for a flush installation in newer homes. Material cost is significantly lower than steel.

Steel beam

Required for longer spans (typically 18 feet+), heavier loads, or where ceiling height constraints prevent a deeper LVL beam. Steel beams are stronger per inch of depth, which is why they often allow a flush installation in older homes where LVL would require a dropped beam. More expensive than LVL, both in material and installation labour (cranes, additional crew, longer installation time).

Flush vs dropped

A flush beam sits inside the ceiling, level with the floor joists above. The result is a continuous flat ceiling with no visible bulkhead. A dropped beam sits below the ceiling line, creating a visible bulkhead or beam feature.

Flush installations cost more (typically $3,000–$8,000 more) because they require cutting and reframing the existing ceiling structure to accept the beam in-plane. Dropped beams are faster to install and less invasive. Some homeowners actually prefer the architectural look of an exposed beam — particularly in Edwardian and craftsman-style homes where it complements original character.

Your engineer will tell you what’s structurally feasible. The flush-vs-dropped choice within that constraint is yours.

Permits, engineering, and what the City requires

Toronto requires a building permit for any work that removes or modifies a load-bearing wall. The application package includes:

  • Stamped engineering drawings showing existing structure, proposed beam specification, and connection details
  • Engineer’s letter confirming the structural design
  • Site plan and floor plan showing the affected area
  • Building permit application and applicable fees

Permit fees for load-bearing wall removal projects in Toronto typically range from $500 to $2,000, depending on the project's value. Standard review takes 2–6 weeks; FASTRACK runs 5–10 business days for eligible projects under 100 m².

Heritage-designated properties in Forest Hill, Rosedale, The Annex, and Cabbagetown may also require a Heritage Alteration Permit if the work affects exterior elements visible from the street. Interior-only wall removals usually do not trigger heritage review, but verification by the City is part of the standard application process.

Skipping the permit is one of the most expensive mistakes a Toronto homeowner can make. Unpermitted structural work creates problems at resale (forced post-completion permit applications cost 2–3x more), insurance (claims involving unpermitted structural changes can be denied), and inspection (any future renovation that uncovers it triggers retroactive compliance requirements).

Cost breakdown: what drives the final number

A representative $36,000 load-bearing wall removal project in Toronto breaks down approximately as follows:

  • Structural engineering and drawings: $2,500
  • Building permit and fees: $1,200
  • Temporary supports and demolition: $3,500
  • LVL beam material and hardware: $4,500
  • Beam installation labour (3-day install, multi-trade crew): $7,500
  • Electrical relocation (light switches, outlets, ceiling fixtures): $2,800
  • HVAC duct relocation if required: $3,500
  • Drywall, ceiling repair, mudding, sanding: $4,500
  • Flooring patch and refinishing where the wall met the floor: $3,500
  • Paint and trim restoration: $2,500

Total: $36,000

The biggest variables that move this up or down:

  • Beam type and span: Steel beam adds $5,000–$12,000 over LVL for the same span
  • Flush vs dropped: Flush installation adds $3,000–$8,000
  • Trade relocations: Walls with HVAC ducts, plumbing stacks, or major electrical runs cost significantly more than empty stud walls
  • Floor and ceiling restoration: Hardwood that needs to be patched and refinished across a large area can add $4,000–$8,000
  • Older home conditions: Knob-and-tube wiring discovered during demolition, asbestos in original plaster, or unexpected water damage all add scope

How long does load-bearing wall removal take

Plan for 8–14 weeks total from initial consultation to final paint, broken down approximately:

  • Engineering and drawings: 2–3 weeks
  • Permit application and approval: 2–6 weeks (FASTRACK can be 5–10 business days)
  • Material procurement and scheduling: 2–4 weeks
  • Active construction (demolition through final paint): 2–4 weeks

When the wall removal is part of a larger kitchen renovation, the timelines compress because the engineering, permitting, and demolition phases run in parallel with kitchen design and cabinet procurement. A typical kitchen renovation with wall removal takes 12–16 weeks total, versus 8–14 weeks for wall removal alone.

The single biggest schedule risk is permit approval timing. Submitting a complete, engineer-stamped package on the first attempt is the strongest predictor of staying on schedule.

Common mistakes to avoid

The patterns that turn clean wall-removal projects into expensive ones are predictable.

  • Cutting first, engineering later. Once a load path is disturbed, options narrow and costs climb.
  • Skipping the permit. Unpermitted structural work creates resale, insurance, and future renovation problems that cost 2–3x as much to resolve later as to do correctly upfront.
  • Underestimating ceiling and floor restoration. The visible "after" depends as much on the surrounding finishing as on the structural work itself.
  • Choosing a contractor without structural experience. General renovators who do occasional wall removals miss details that specialists catch — bearing point design, proper connection hardware, and code-compliant fire blocking.
  • Ignoring HVAC and electrical systems that pass through the wall. These almost always need to be relocated, and the cost is non-trivial.
  • Not coordinating with the surrounding renovation scope. Removing a wall as a standalone project, then renovating the kitchen six months later, costs 25–40% more than doing both together because trades and finishes are duplicated.

Why fixed pricing matters for wall removal

Load-bearing wall removal has more variables than most renovation work — engineering scope, permit complexity, beam specification, hidden conditions in older homes, and multi-trade coordination. Estimate-based quotes leave room for all of these to surface as line-item charges during construction.

A fixed-price contract bundles engineering, permits, structural work, and finishing into one transparent number before work begins. You only pay extra if you voluntarily add scope. Maserat has been WSIB-certified and Family-Run since 2017, with 50+ completed projects and a 4.9 Google rating. Every wall-removal project includes structural engineering coordination, full permit handling, and a fixed-price quote.

Ready to evaluate a wall removal for your home?

Every home is different — load paths, beam options, surrounding scope, and finishing choices all affect the final number. The most efficient way to get an accurate budget is a free in-home consultation where we assess what’s structurally possible, what permits are required, and what scope makes sense for your goals.

Book your free consultation or call us at (416) 876-1052.


FAQ
